“Help us achieve the potential for our new space” - CEO @ Courtside

Courtside Video Entertainment is a startup focused on embedding screen in basketball arenas to enhance the fan experience during the game, especially the VIPs on the sidelines.

After a few prototype builds to support pilots with college, the decision was made to setup their own assembly in the heart of Philadelphia, in an old abandoned brick building.

We worked closely with the CEO and CTO to design the space and organization to maximize production capacity and operator the operator experience. They shared all the ideas, process information, Bill Of Materials and supply chain data. We are designing assembly line, supporting inventory space and the build out timeline to ensure they can scale production to meet customer demand.

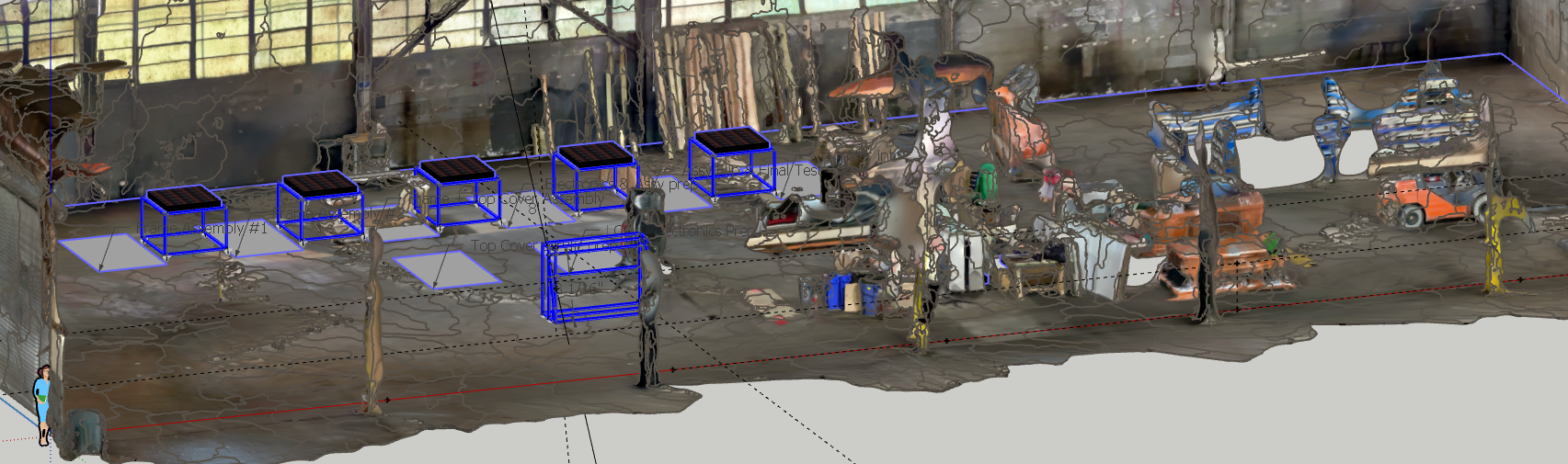

An aerial or panoramic view of an indoor warehouse or workshop space with various equipment, tools, and objects scattered across the floor, and a partially destroyed or damaged wall around the perimeter.

Project Showcase: Courtside Video’s Electronics Assembly Line

Before

Static Adverts

After

Embedded Display Adverts

Our Approach

Our principal, Ahmed, served as fractional VP of Operations & Supply Chain, designing an organization that maximizes revenue per employee to support competitive local pay.

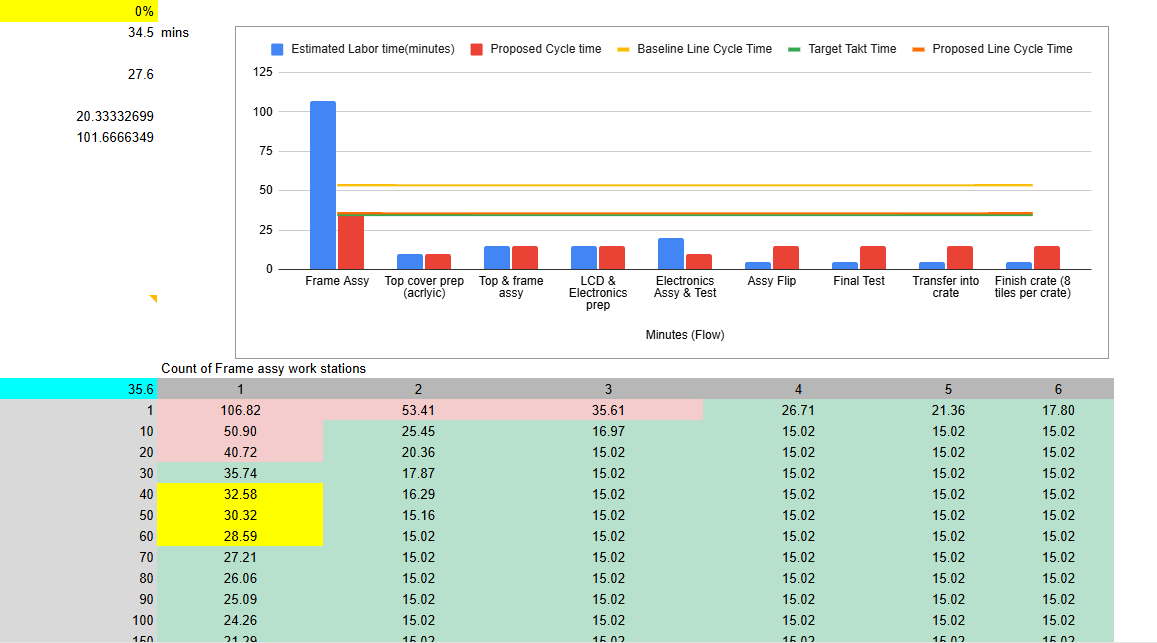

The factory floor prioritizes flow for the assembly operation. ERP selection maximizes automation and minimizes overhead spend, with field service optimized through tailored material handling solutions.

Before

Leased Factory

After

Scalable Manufacturing
Floor Space Optimized

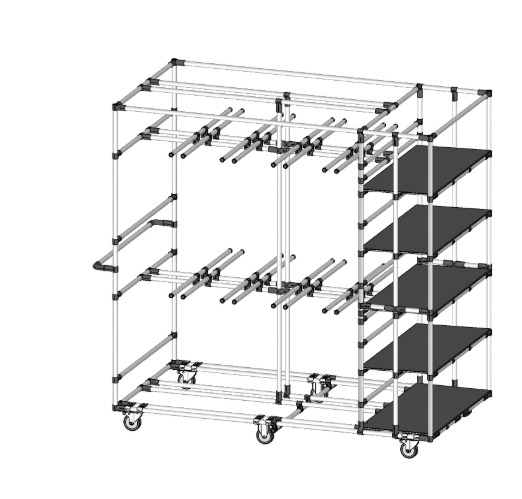

Material Handling

The Outcome

The flow-optimized factory floor now outputs 10 tiles per day, scalable up to 20 per day. A 90-day plan for factory buildout came with streamlined equipment sourcing — and there’s more to come as Courtside grows.

10 → 20 Tiles/Day
Scalable, flow-optimized output

90-Day Buildout
Streamlined equipment sourcing

$50M+/yr Revenue
Supported by the new assembly line
